Marlin Basin Kitchen
The kitchen in the film. We traded three sliding windows for one steel wall and let a fourteen-foot slab of Calacatta do the talking.
Design-build remodeling · Coral Gables
A 1994 kitchen in Gables by the Sea. Eleven weeks, one camera move. Scroll to build it.
Demolition & structure

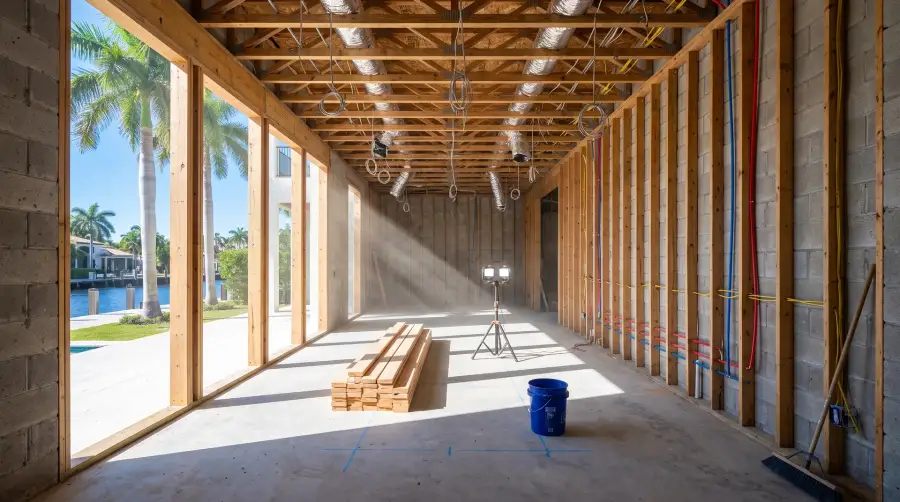

Week 3.
Down to block and trusses. Three openings cut and framed for a window wall. Rough plumbing and electrical in, inspected.
Plaster, steel, stone
Week 8.
Walls skimmed white, steel windows glazed, cabinetry scribed to the block. The island is templated, cut and carried in as three slabs.
Keys handed over · March 2026
Week 11.Home.
On the week we promised, at the price we wrote down.
The firm
Selected work · 2024–2026

01
The kitchen in the film. We traded three sliding windows for one steel wall and let a fourteen-foot slab of Calacatta do the talking.

02
Seven feet wide and it stays seven feet wide. The original terrazzo was under two layers of tile.

03
Three slabs from one block, numbered at the quarry, so the vein runs over the corner without a break.

04
A 1926 house gutted badly in the eighties. We put the proportions back, opened the great room to the loggia and rebuilt every system behind the plaster.
Your turn to do the demolition

Same walls, same window position, same morning sun. We opened the glass block to a full-height steel window, lost the step-up tub and turned the shower into the one loud thing in the room.
Scope & prices
Full gut and rebuild. Shop-built millwork, slab stone, moved plumbing, new openings, impact glazing.
from $95k10–16 weeks on site
Primary suites and secondary baths. Curbless showers, slab and handmade tile, new windows, floor heat.
from $48k6–10 weeks on site
1920s to 1990s houses. Additions, structure, roof, every system behind the walls, interiors and terrace.
from $450k7–14 months on site
Ranges come from our last 33 completed projects, 2023–2026. Your proposal is a fixed price with a week-by-week schedule attached. If we miss the handover week for a reason that is ours, we pay you $500 a day until we hand over.
Week by week
This is the actual schedule from the kitchen in the film. Nothing is demolished until every cabinet, slab and hinge has a delivery date, which is why the site never sits empty.
Before week 1
Protect & demolishWeek 1 · floors and AC sealed, room stripped, debris off site daily
Structure & openingsWeeks 2–3 · block cut, tie-beams and headers, framing
Rough-in & inspectionsWeeks 3–4 · plumbing, electrical, AC, city sign-offs
Close up & plasterWeeks 5–6 · insulation, board, level-5 skim, ceiling
Floors & steel windowsWeeks 6–7 · limestone set, impact steel glazed
CabinetryWeeks 7–8 · shop-built oak delivered, set and scribed
StoneWeeks 8–10 · laser template, fabrication, install day
Fixtures, paint, appliancesWeek 10 · everything switched on and tested
Punch list & keysWeek 11 · walk-through with you, deep clean, handover
Google and Houzz · most recent September 4, 2026
“The proposal was a fixed number and eleven weeks later the final invoice was that number. They texted a photo every Friday with the week circled on the schedule.”
“Our board is difficult. They handled every submission, the elevator bookings and the neighbors downstairs. We were in Maine the entire time and came back to a finished kitchen.”
“I asked three contractors how long a bathroom takes. Two said ‘it depends.’ These guys handed me a nine-week chart and then hit it.”
“They found the original 1926 beams above a dropped ceiling on the first visit and redrew the whole great room around them. Thirteen months, no surprises on price.”
Chapter two · Marlin Basin Residence
Whole home · Coral Gables · 2026
6,100 sq ft.14 months.One team.
Golden hour, the first evening home
Your turn.
The first visit is an hour on site with an architect, not a salesperson.
Contact
You get a written scope and a realistic range within a week of the visit. No charge, no follow-up calls unless you ask for them.
